SaaS Development Cost in India (2026 Guide)
What drives SaaS development cost in India, a method to size your own build, the running costs people forget, and why serious quotes are fixed per phase.

The short answer: cost follows scope, and scope has a handful of drivers
Nobody can give you an honest figure for "a SaaS" in one line, because the word covers a three-screen internal tool and a multi-tenant platform with billing, roles, integrations and mobile apps. Both are called SaaS. They differ in effort by an order of magnitude, and effort is what you are paying for.
So this page does not print a price table. We do not publish project prices, and a number copied from a blog would be an average across projects that cannot be compared. What it gives you instead is something you can check: the formula behind every software quote, the eight drivers that move the effort part of it, a method for sizing your own product on paper before you talk to anyone, and the running costs that never appear in a build quote.
If you already have a scope and want a real number, the route is a call, a written scope and a fixed quote for the first phase. Project pricing explains how that works, and our SaaS development service describes what a build with us covers. If you are still deciding what to build, read on and do the sizing exercise first. It takes an afternoon and it makes every conversation afterwards shorter.
The formula behind every quote

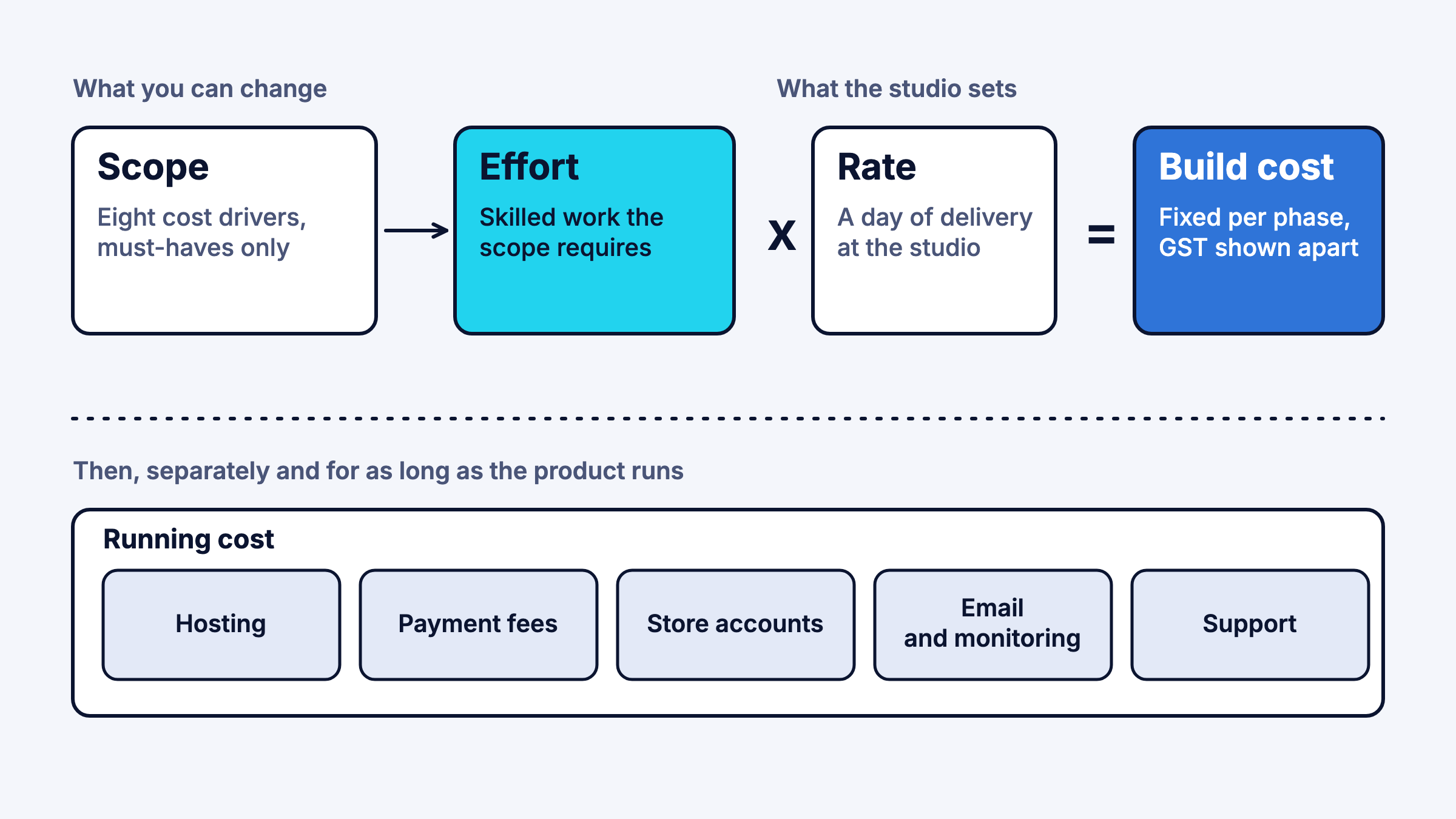

Every software quote, from every studio, is a version of this:
build cost = effort x rate, plus third-party costs, plus tax
Then, separately and forever: running cost.
Effort is the amount of skilled work the scope requires. Rate is what an hour or a day of that work costs the studio to deliver, which is more than a salary: it includes design, testing, project management, the time spent on calls, the tools and the idle days between projects. Third-party costs are things you pay other companies for, such as a design asset licence or a paid API. Tax is GST on the invoice, which you should ask every vendor to state separately so that quotes are comparable.
India matters in this formula through the rate only. A studio in Tamil Nadu and a studio in Texas read the same scope and arrive at roughly the same effort. The difference is what a day of that effort costs. It does not change how many days a multi-tenant billing system needs, which is why a quote that is dramatically lower than the others is rarely cheaper engineering. It is usually less effort assumed, and you find out which features that removed when the first change request arrives.
That is also why comparing hourly or daily rates alone is a poor way to choose. A lower rate on a larger assumed effort costs more than a higher rate on a scope that was understood properly. The number worth comparing is the total for a defined scope, and the scope has to be written down before the numbers mean anything.
Eight drivers that move the effort
Almost everything that makes one SaaS cost more than another falls into these eight. For each, the useful question is not "do we need it" but "how deep does it need to go in the first phase".
| Driver | What adds effort | The question to ask |
|---|---|---|
| Multi-tenancy | Every record belongs to one customer, and nothing may leak across the boundary | Is each customer a company with its own users, or a single person? |
| Accounts and roles | Sign-in, password reset, invitations, teams, permissions per role | How many distinct roles, and who can see whose data? |
| Billing | Plans, trials, upgrades, invoices, failed payments, tax | Do you charge from day one, or can the first release be invoiced by hand? |
| Integrations | Each external system has its own rules, limits and failure modes | Which ones are needed to get the first paying customer? |
| Data in and out | Importing existing data, exports, bulk operations | What do customers bring with them, and in what format? |
| Admin and support tools | Looking up a customer, fixing a record, seeing what happened | Who will run this when something goes wrong, and with what screen? |
| Mobile | A second client, store accounts, review cycles, push notifications | Is a responsive web app enough for the first phase? |
| Security and compliance posture | Audit trails, encryption choices, data protection duties | What will your first enterprise customer ask in the security review? |
Two of these deserve a word more, because they are the ones that surprise founders.
Multi-tenancy is cheap to design and expensive to retrofit. In the HR platform we are building in house, every link between records carries the tenant, so the database itself refuses a task in one employer pointing at another employer's record. That decision costs very little at the schema stage. Added after there is customer data, it is a migration across every table, and a security review across every query. If your product will serve more than one customer organisation, this belongs in the first phase even if the second customer is a year away.
Data in and out is the quiet one. Our Finance Tracker work is built around importing statements, because an app that depends on typed entry gets abandoned. The import turned out to be the hard half of the product: formats differ per bank, some arrive as password-protected PDFs, and the same transaction can appear twice through two routes. Whatever your product receives from the outside world, assume the intake is a larger piece of work than the screen that displays it.
Sizing your own product on paper
You can estimate relative effort without any prices, and it is worth doing before you request quotes. The method is deliberately crude, because a crude estimate made by you beats a precise one made by someone who has not heard your problem.
- List the capabilities, not the screens. "A customer can invite a teammate" is a capability. "Settings page" is not.
- Mark each one must-have for the first paying customer, or later. Be strict. The later list is where the savings are.
- Size each must-have as small, medium or large, using the drivers above. Anything that touches money, another customer's data, or an outside system is at least medium.
- Count the large items and the outside dependencies. Those two numbers predict the spread between a low and a high quote better than the total number of features.
- Write the exclusions down. What the first phase deliberately does not do.
Here is the exercise on an invented product, so the shape is visible. Suppose a founder wants a booking tool for independent gyms. It is hypothetical and the sizes are judgement, not measurement:
| Capability | First phase? | Size | Why |
|---|---|---|---|
| A gym owner creates classes and capacity | Yes | Small | Plain records with validation |
| Members book and cancel | Yes | Medium | Capacity rules and concurrent bookings |
| Several gyms on one platform, fully separated | Yes | Large | Tenant boundary through every table and query |
| Staff roles: owner, trainer, front desk | Yes | Medium | Permissions per role, per gym |
| Card payments for memberships | Later | Large | Billing, failures, tax, reconciliation |
| Import existing members from spreadsheets | Yes | Medium | Messy input and duplicate handling |
| Mobile app for members | Later | Large | Second client, store accounts and review cycles |
Reading it: the first phase has one large item and three mediums. Move payments and the mobile app into it and the first phase has three large items and two outside dependencies, which is a different project with a different range. The founder who sees this on paper can decide to start with invoiced memberships and a responsive web app, learn what gyms actually use, and scope payments with real usage behind it. The founder who does not see it asks three studios for "a gym booking SaaS" and receives three quotes for three different products.
What the products we run teach about cost
Four things from our own builds, each of which shows where effort hides.
- KeyNesta encrypts on the device before sync, so the server stores ciphertext it cannot read. That is the product, and it removes options: no server-side search across entries, no password reset that recovers a vault. A decision like that is cheap on day one and a rewrite on day three hundred. How KeyNesta was built sets out the trade-offs.
- MenuFly is a QR menu platform that renders a real mobile page instead of pointing at a PDF, edited by the restaurant in a builder, so the code on the table never changes when a price does. The effort is in the builder, not the page.
- The HR platform deliberately leaves payroll for last, because payroll is only as correct as the attendance and leave balances beneath it. Ordering the work by dependency is a cost decision: a module built on an unproven base is built twice.
- Our tool platform, with 132 browser tools, taught the opposite lesson: many small, similar pieces are cheap when they share one engine and expensive when each is custom. When you can express your product as a few reusable pieces, say so in the brief.

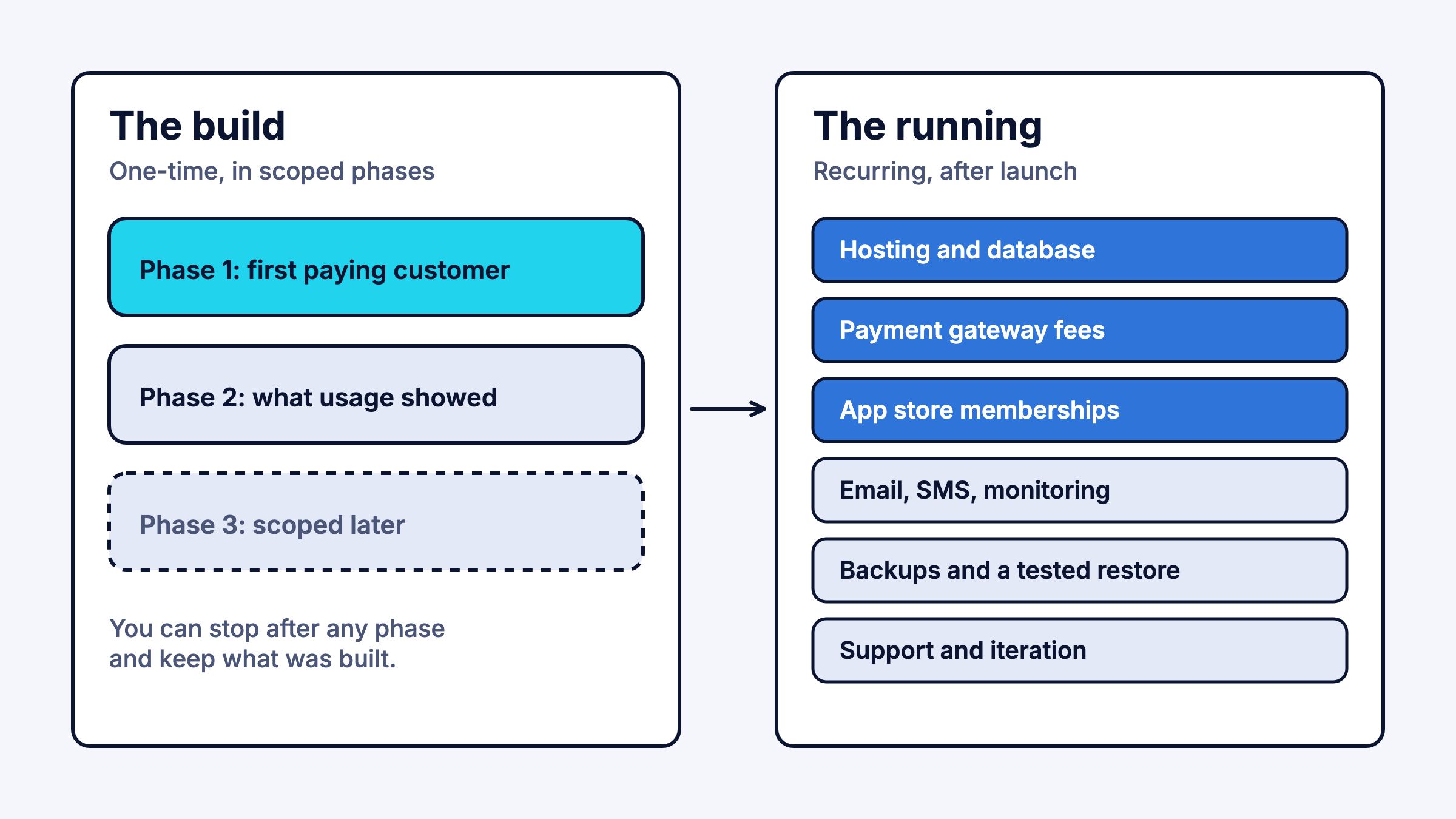

The costs that are not in the build quote
A build quote covers building. The product then has to run, and these lines arrive after launch. None of them is large against a build, but all of them are recurring, and a budget that omits them is wrong by the end of the first year.
- Hosting. On a managed cloud database, pricing is metered. AWS states that RDS for PostgreSQL is billed per DB instance-hour, with storage billed separately and continuing while an instance is stopped. The size of that bill follows your usage and your architecture, and an honest studio will tell you which parts of your design make it grow.
- Payment fees. If you charge customers, the gateway takes a cut of each transaction. Razorpay's published pricing lists 2% per successful transaction on its standard domestic rate, with 18% GST charged on that fee (checked October 2026). Model it into your plan prices rather than discovering it in the first settlement.
- App store accounts, if there is a mobile app. Apple's Developer Program is 99 USD per membership year, and Google Play charges a one-time 25 USD registration fee. They must be in your name, not the studio's.
- Email, SMS and monitoring. Transactional email, error tracking and uptime checks are small lines each and add up. Ask which ones the design needs.
- Backups and a tested restore. Storage is cheap. The cost is the time to prove a restore works, which is a one-off task that should be in a phase, not a surprise.
- Support and iteration. Someone has to answer the first customer who cannot sign in. Decide whether that is a retainer, a later phase, or your own team.
Two compliance notes belong here, because they change effort rather than running cost. India's Digital Personal Data Protection Act, 2023 applies to products that handle personal data of people in India, and its duties include notice, consent and reasonable security safeguards, so ask any studio how they build for it. And on certifications: BitsSolved holds no SOC 2, ISO 27001 or HIPAA attestation, and says so. If an enterprise customer will require one, that is a separate programme with its own auditor and its own cost, and it should be on your plan before the build is scoped, not after.
Why we quote per phase, and what a good quote contains
A single fixed price for a whole, unscoped product is either padded for every unknown or doomed to a dispute in month three. So we quote a scoped phase at a time, with a fixed price agreed in writing before work starts. You can stop after any phase and keep what was built, and the code, servers and accounts are in your name from the first commit. The reasoning is set out in full on the project pricing page.
Whoever quotes you, the same list of questions separates a quote from a guess:
- What exactly is in scope, and what is excluded? Exclusions matter as much as inclusions.
- Is it fixed or time-and-materials, and per what? A fixed price per phase is different from a fixed price for everything.
- What is assumed about integrations, data import and mobile? These are the drivers above, and each should be a stated line.
- Does the price include GST, hosting set-up, and the handover? Ask for tax separately.
- Whose accounts will hold the repository, the servers and the domain? The answer should be yours.
- What changes the price, and how is a change handled? In writing, before the work continues.
If you are unsure what to put in front of a studio, writing a software brief that gets an accurate quote sets out eight answers that make quotes comparable. The older overview of SaaS app development in India covers the stack and the stages of a build.
Frequently asked questions
How much does it cost to build a SaaS product in India?
It depends on the scope, specifically on the eight drivers above, so any single figure would be wrong for most products. The honest route to a number is a written scope for the first phase and a fixed quote against it. The sizing exercise on this page gives you the relative shape before any quote arrives.
Is a SaaS MVP cheaper than a full product?
By design, yes, because the first phase excludes everything that is not needed for the first paying customer. The saving only exists if the exclusions are written down. A minimum product that quietly includes billing, mobile apps and three integrations is not minimal.
Why are Indian quotes lower than US or European ones?
The rate differs, because a day of delivery costs less. The effort for the same scope is the same. Be wary of a quote far below the others: it usually assumes less work, and the gap shows up later as change requests.
Should I pay per hour or for a fixed phase?
For a defined scope, a fixed price per phase moves the risk of estimation onto the studio and gives you a number you can plan around. Time-and-materials suits work that cannot be defined yet. Either way, you should see a written scope.
What costs continue after launch?
Hosting, payment fees if you charge, app store memberships if you have an app, email and monitoring, backups and support. None of them appear in a build quote, so ask for them separately.
Do you build SaaS for founders outside India?
Yes. The first call is free, and it is mostly us asking the questions in the sizing exercise above.
Start here
- List your capabilities and mark the must-haves for the first paying customer.
- Size each one small, medium or large, and count the large items and the outside systems.
- Write the exclusions for phase one.
- Ask each studio for a fixed quote against that same list, with GST shown separately.
- Ask whose name the repository, servers and domain will be in.
If you would rather do the sizing with someone who builds these products, that is ordinary work for us: SaaS product development for a new build, and for a product that already exists and needs a second opinion before you spend more on it, SaaS architecture and technical advisory. The first call is free, and BitsSolved is a small studio in Tamil Nadu, India, so the person who scopes your product is the person who builds it.
